Lets Be Evil

Without Villains, There Would Be No Heros.

Below is the TL;DR for how to run meetings like a Super Villain.*

New Business

Announcements. Process New Work - Assign ToDos & Due Dates

Completed Work

Acknowledge work Completed this cycle - Congratulate Team Members!

Unplanned Work

Assign Unplanned Work for the Upcoming Cycle

The Meeting Has Concluded

Card Master should bang the gavel. Release to Recess.

* Continue reading for the full process.

Pull Requests Welcome

Find us on Github


What is a Super Villain?

Super Villains can be any team member that likes organizing things.

What Are They?

  • Villains Plot, Plan and scheme - They Help Meetings Run
  • Ideally, a team should have multiple villains, and rotate them from cycle to cycle.

Responsibilities

  • Running the pre-standup meta meeting
  • What went well last time?
  • What can we do better?
  • What does work generally look like this cycle? (Load, etc)
  • Ensure Blocked cards have clear unblock Task.
  • Resolving as much scut work as possible prior to the meeting.
  • Recording load on each Responsibility Lane from week to week
  • Protector of the realm (but mostly everyone's time)
  • Responsible for starting the meeting on time and ending as quickly as possible.
  • Trains other Card Masters - The more the better!

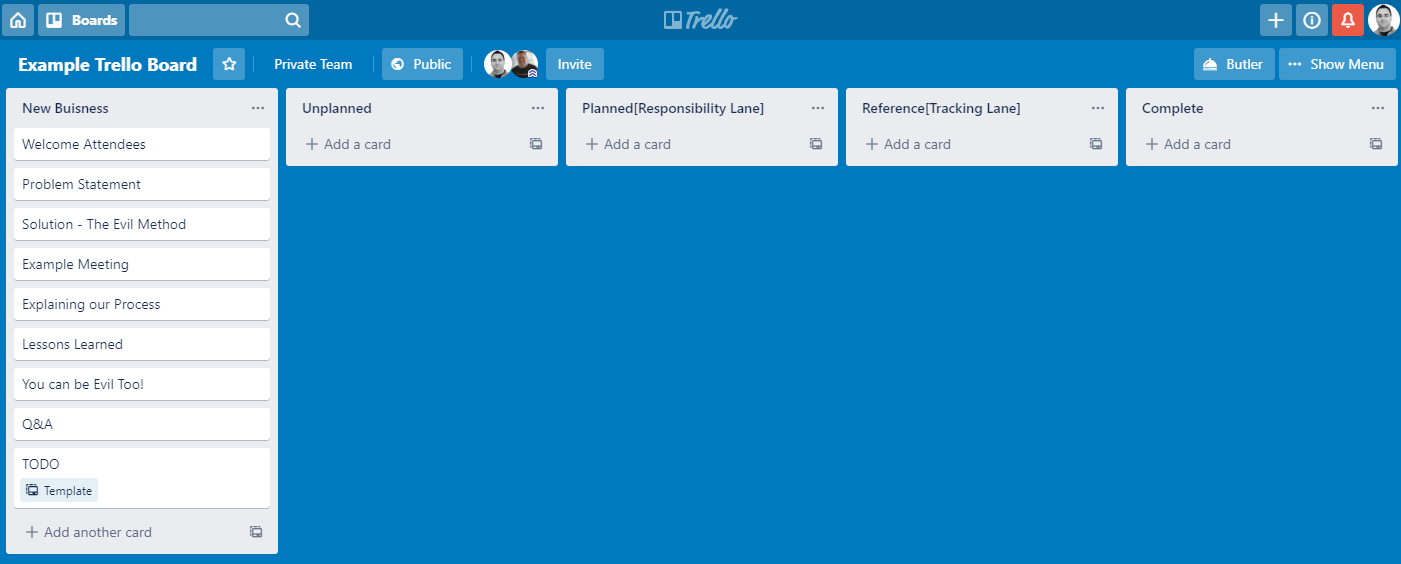

Lanes

Stay in your lane... Until meeting time.

New Business

“Unrefined Material”

  • All lane changes occur during planning meetings.
  • “Unrefined material” - Must have a potential due date.
  • Announcements for the next meeting
  • Problems with no defined solution
  • Unidentified “complaints”

Unplanned

"Refined, but not assigned."

  • Work that has been touched and defined but not been assigned
  • Contains a due-date, at least 1 associated team member, goals that can be completed in 1 “cycle” - where a cycle is defined as the time between team standups.

Blocked

“Stalled, due to outside factors.”

  • Blocked items cannot be actioned until the block is resolved.
  • Blocked card must have a clearly defined unblock task
  • Possibly send alerts to slack / notify team or manager

Responsibility [multiple]

“Promised work, per cycle”

  • Lane per group, for defining workload
  • Workload should be broken out by generalized types of work done by the team.
  • On an assembly line you might separate bolting parts together from painting the car.
  • Lane Capacity estimation formula:

    $workers * $estimated_work_per_cycle

Tracking [multiple]

“Not Cycle dependant work”

  • Kept for reference
  • Items to be aware of, but not completed on a specific cycle.
  • Complete

    “Finished products go here”

    • “Finished and kept in a lane until archived”
    • Cards need somewhere to go after they’re completed.

    Rules

    I'm a Villain, don't I make the rules? No - You're a Super Villain. Super Villains maliciously comply.

    Here's the starter rule set.

    • All work enters at the New Business lane.
    • All work moves between lanes during a standup*
    • Transactions are not Work.
    • All cards should move through lanes at the standup.
    • Last - You must be in eye sight of the car before claiming shotgun. (This is not negotiable.)
    • * It’s OK to add comments, change members and provide possible solutions to cards, but NOT ok to move them between meetings.

    Process

    Rules... all the way down.

    The Lawful Evil Process, Longform.

    • Users populate to the New Business Lane between cycles
    • Card Master for the week reviews lanes before meeting.
      • Looking for missing information on New Business items
      • Comparing unplanned work for the coming week to estimated capacity in each lane.
      • Pushing unplanned work due dates where possible
      • Following up with team members individually to fix placeholder cards and confirm changes in
    • Clear any cards in New Business
      • Determine if a card is:
        • Announcement (No action needed)
        • Complaint (Card should be reworked)
          • See “1-minute redirect”
        • A Transaction - Transactions are problems with well defined solutions. These should not be processed.
        • Problem (Solutions should be suggested!)
      • Collaborate solutions to the card
        • Define the problem as well as possible
        • Brainstorm a TODO list of items that can be completed in a cycle
          • Now is NOT the time to solve the problem
          • See “1-minute goals”
        • $ESTIMATE_POKER_PLACEHOLDER
        • Move to Unplanned
    • Move any finished cards to Complete
      • Review cards marked as completed
        • This is a chance for discussion and praise
        • See 1-minute manager “1 minute praise”
      • As part of the review of completed work -
        • Consider any new work that resulted.
        • Consider if this class of problem can now be transactional
          • See “Andon cord”
    • Review work Planned for the current cycle
      • Determine if work is blocked
      • Determine if work is expected to be completed by the start of next cycle, or if due date needs to be updated.
        • Team member responsible for the card should ultimately determine the timeline.
        • External pressures such as other work that is blocked or external deadlines should be considered.
        • Any card with a new due date past the next cycle, should be moved back to Unplanned.
      • Ensure all cards have a touch / comment / due date adjustment by end of cycle.
    • Drain Unplanned work due before next cycle
      • Move any work due within the next cycle to the appropriate lane
      • Decide if any lane is overloaded, adjust if possible
    • End the Meeting.
      • There should be a defined and concise step to end the meeting.
        • This prevents end of meeting add-ons and off topic discussion.
        • Team building is great - but stand-ups aren't the time.

    Resources

    We get by with a little help from our friends.
